Sprint Metrics Report

Document Change Control

Release No Release DateIssued ByVersion CommentClickUp Version Time
1.023/1/2025Ahmed ShehataInitial Version Mar 02 11:50 am
2.030/9/2025Ahmed ShehataUpdating MetricsOct 07 2:32 pm

List Of Approvers

Name TitleApproved Release No
Tarek Ramadan Software Engineering Director 2.0

Sprint Metrics Report

Project NameEnterprise architecture
Release NoRelease 1
Sprint NoSprint 6
Issue Date3/3/2025
Issued ByAhmed Essam
Reviewed ByAhmed Shehata

MetricTargetSnapshotActual ValueRCAComment(s)

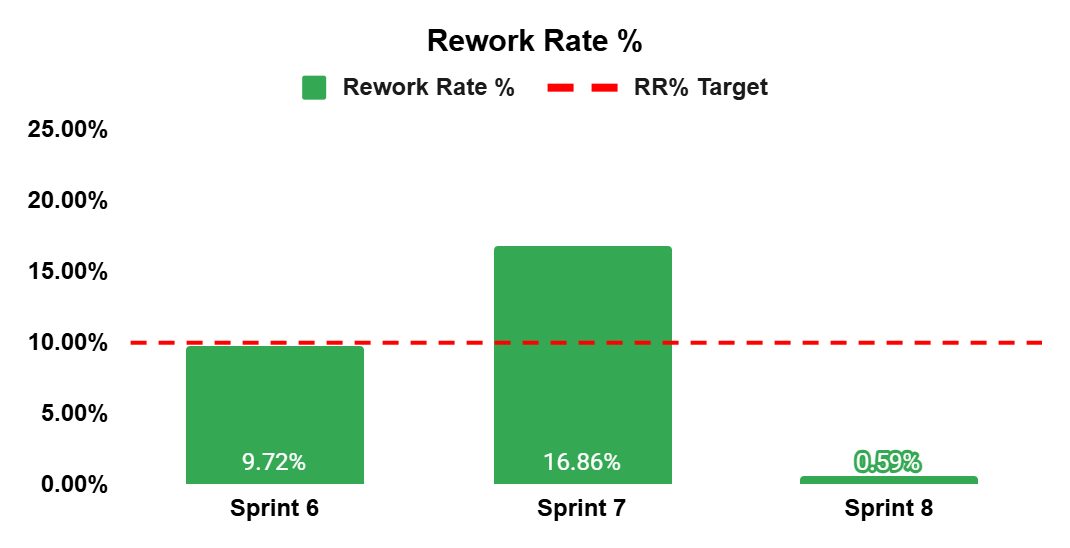

Sprint Rework Rate<=10%9.72

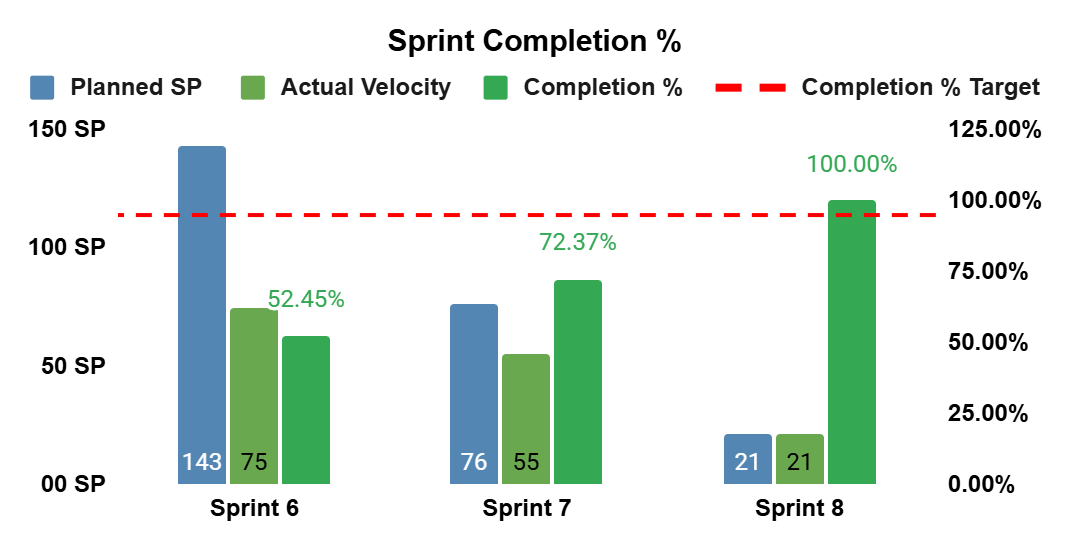

Sprint Burn-down>= 95%52.45total assigned scope isn't equal the team capacity. if we see to the velocity we will find that 75 story points

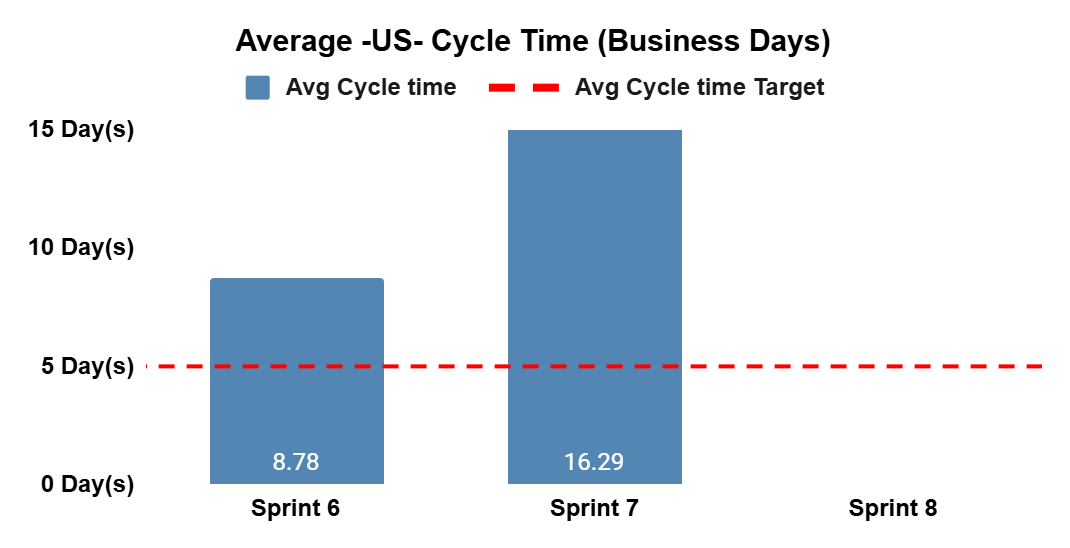

Average Cycle Time of US per sprint<= 58.78

Weighted Defect Density (WDD)<= 20.5

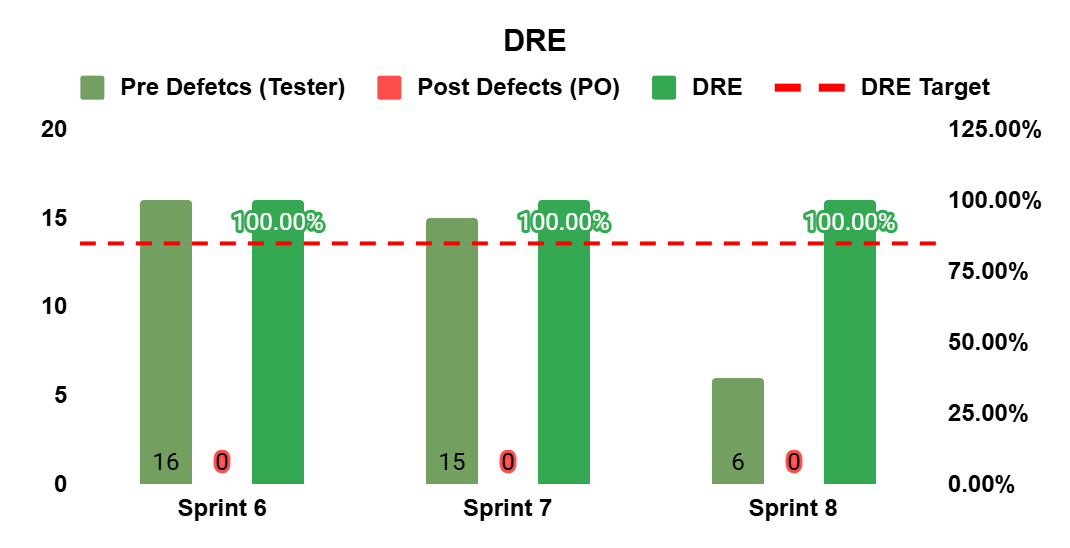

Sprint Defect Removal Efficiency (DRE)>= 85%100%

Recommendations & Actions after Sprint 6

Total assigned scope isn't equal the team capacity. if we see to the velocity we will find that 75 story points → commit in the sprint scope only not to the all backlog scope (TL - SM)
